Three-Point Estimation

Agenda

What we'll cover:

  • What is task/project estimation
  • The three-point estimation
  • Other considerations

What is estimation ?

and why can it be so hard ?

What is a good project ?

A good project is a project that delivers:

  • Expected features
  • On time
  • On budget
  • With expected quality

What is a good estimation ?

  • As accurate as possible
  • Not too optimistic
  • Not too pessimistic

Spoiler alert!

Human brain is not good at making estimates.
Me
(and every objective human being)

Why is it difficult ?

We all have cognitive bias

  • Wishful thinking
  • Anchoring / Focalism
  • Planning fallacy
  • Cognitive dissonance

Questions to ask yourself

  • How complex and big is the project ?
  • Have we ever made something like this ?

Common estimation scenarios

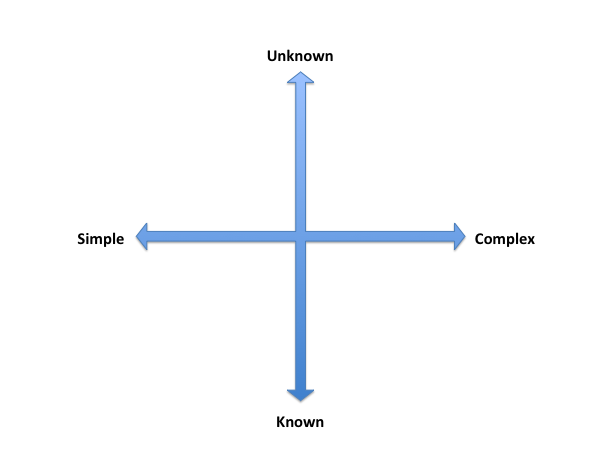

Project types

To estimate a project...

... cut it in consistent tasks.

Three-point estimation

Pre-requisites

Before getting into three-point estimation, we need a little background in...

Maths and probabilities

Normal (or Gaussian) distribution

Input

Take three figures (points):

  • b = the best-case estimate
  • m = the most likely estimate
  • w = the worst-case estimate

Estimation

Estimation is a weighted average.

e = (b + 4m + w) / 6


And standard deviation

σ = (w − b) / 6

Example

  • b = 2d
  • m = 4d
  • w = 10d

e = (2 + 4*4 + 10) / 6 = 4,666...

σ = (10 − 2) / 6 = 1,333...

Confidence level

Use SD to add confidence level:

  • Confidence level in E ± σ is 68%
  • Confidence level in E ± 1,645σ is 90%
  • Confidence level in E ± 2σ is 95%
  • Confidence level in E ± 3σ is 99.7%

Group estimation

You can estimate in group:

  • It reduces bias
  • It adds more expertise
  • It involves the team (which is good)

Project estimation

To estimate a project based on tasks estimation (e):

E = Σe

SD = √(Σσ^2)


The more subtasks you estimate, the more precise your project estimation will be.

Other considerations

When estimating, never forget that

  • Ressources are never 100% productive
  • Context switching has a cost
  • Management time, meetings and contingence has a cost too
  • Cognitive bias tend to make estimations too optimistic
  • Those who estimate are not necessarily those who are going to do

Also, for a project

Effort and costs are different from delay / planning

(but you have PERT to solve that)

Other methods

  • Monte Carlo Simulation
  • *Function points
  • COCOMO / COSYSMO
  • Story points and Planning poker
  • PROBE
  • Use Case Points
  • Putnam

and a thousand more...

Thank You!

jc.bohin.net/speak-three_point_estimation-steam_learn

Questions ?
